Building a custom home in Delray Beach costs between $450 and $900 per square foot in 2026, depending on finish level, lot condition, and whether the build sits in a coastal flood zone or historic district. A typical 4,000 sq ft custom build runs $1.8M to $3.6M all-in, with ultra-luxury waterfront projects pushing past $5M.
Hard construction accounts for roughly 70 to 75 percent of that number. Soft costs (design, engineering, permits, impact fees) add another 10 to 15 percent, and site preparation, allowances, and contingency fill the rest.
This guide breaks down what actually drives those numbers in Delray Beach specifically, the Florida Building Code requirements that add 10 to 15 percent to any coastal project, the hidden allowance overages that catch most first-time custom buyers off guard, and the realistic timeline from first design meeting to final walkthrough. Figures below reflect current conditions in Palm Beach County and are based on projects completed by EG Homes Florida and comparable builders in Delray Beach, Boca Raton, and surrounding municipalities.
Table of Contents
- What drives custom home cost in Delray Beach
- Cost by home size (3,000 to 7,000+ sq ft)
- Cost by finish level: entry, mid-range, luxury, ultra-luxury
- Hidden costs most builders don’t mention
- Timeline from design to move-in
- How to lower cost without lowering quality
- Real project examples from Delray Beach
- Frequently asked questions
What Drives Custom Home Cost in Delray Beach
Seven factors move the per-square-foot number more than anything else when building a custom home in Palm Beach County. Our full-scope new home construction services address every one of them from the first design meeting onward:
1. Lot Condition
A buildable, cleared lot on a quiet inland street is the cheapest starting point. A teardown lot adds $25,000 to $80,000 for demolition and debris removal. Waterfront or oceanfront lots usually require elevation certificates, deeper pilings, and seawall review, easily $100,000 to $300,000 in site work alone.
2. Flood Zone and FEMA Elevation
Properties east of Federal Highway and in Ocean Ridge, Gulf Stream, and Highland Beach often fall into AE or VE zones, requiring finished floor elevations of 8 to 12 feet above sea level. That drives foundation complexity and adds $40 to $90 per square foot. You can check any Delray Beach address against the official FEMA flood maps before you commit to a lot.
3. Hurricane and Wind Code (Florida Building Code)
All of Palm Beach County is in the High-Velocity Hurricane Zone or near it. Impact windows and doors, hurricane straps, reinforced roof decking, and tested cladding systems add 10 to 15 percent to any build compared to inland Florida. Our new home construction services include every structural element required to meet or exceed these codes.
4. Finish Level
Standard finishes vs. imported stone, custom cabinetry, chef-grade appliances, and smart-home integration can double the per-square-foot cost on the same floor plan.
5. Architectural Complexity
A rectangular footprint with a simple hip roof is dramatically cheaper than a cruciform plan with multiple roof planes, a courtyard, dormers, or curved walls. Expect a 15 to 25 percent premium for complex architecture.
6. HOA or Architectural Review Board Requirements
Communities like Seagate, Stone Creek Ranch, and Gulf Stream Golf Club impose material specifications, roof-tile requirements, and minimum square footages that constrain cost downward only.
7. Market Conditions
Palm Beach County construction labor and material pricing in 2026 remains elevated compared to pre-2020 baselines. Lead times on impact windows, custom cabinetry, and natural stone still run 12 to 20 weeks.

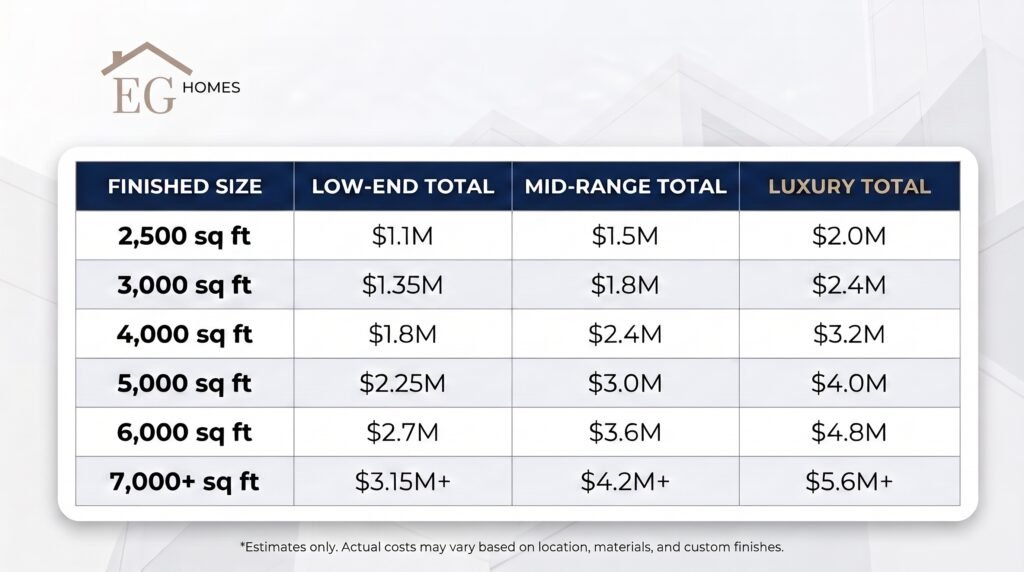

Delray Beach Custom Home Cost by Size
The table below reflects all-in cost (hard costs, soft costs, site work, and standard allowances) for a mid-range custom home in Delray Beach on a cleared inland lot. Coastal, teardown, or historic-district sites add 15 to 35 percent.

These figures assume a two-story build with attached garage, pool, standard landscaping, and typical Palm Beach County impact fees. Oceanfront or Intracoastal lots routinely exceed the luxury column.

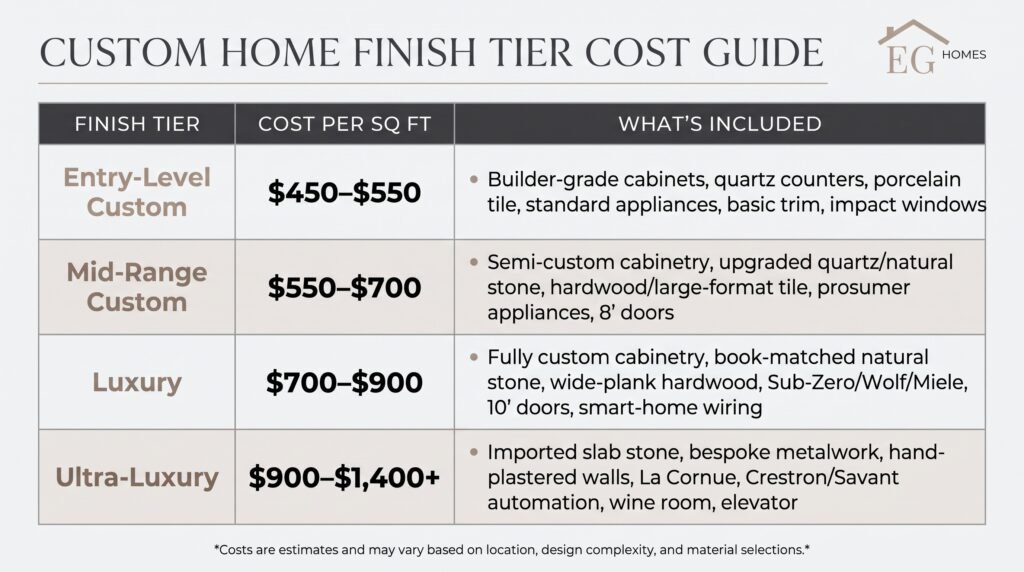

Cost by Finish Level: Entry to Ultra-Luxury
Finish level is where most of the per-square-foot variance lives. Two 4,000 sq ft homes on identical lots can finish at $1.8M or $3.6M depending entirely on these choices.

Hidden Costs Most Builders Don’t Mention
The quoted price per square foot almost never includes these line items. On a $2.5M build, they commonly add $200,000 to $500,000:
- Allowance overages. Builder contracts typically include flat allowances for appliances, lighting, plumbing fixtures, tile, and cabinetry. Clients who choose anything above the allowance pay the difference out of pocket, and most do. Budget 10 to 20 percent above stated allowances.
- Impact fees and permits. Palm Beach County and the City of Delray Beach charge impact fees for roads, schools, parks, and utilities. On a 4,000 sq ft home, expect $25,000 to $45,000 in combined fees before a single shovel hits the ground. For the exact fee schedule and submittal requirements, go directly to the Palm Beach County Building Division.
- Site survey, geotechnical report, and soil testing. $5,000 to $15,000 depending on lot complexity.
- Architect and structural engineer fees. 6 to 12 percent of hard construction cost if hired separately; often bundled into design-build contracts.
- Elevation certificate and flood vent requirements. Mandatory for AE/VE zone builds; $2,500 to $8,000.
- Driveway, hardscape, landscaping, irrigation. Rarely included in base pricing. Budget $75,000 to $250,000 for a complete package.
- Pool and spa. $120,000 to $350,000 for a standard pool with spa, decking, and screen enclosure.
- Final punch-list and warranty reserve. Reputable builders hold back 5 percent for completion and warranty work.

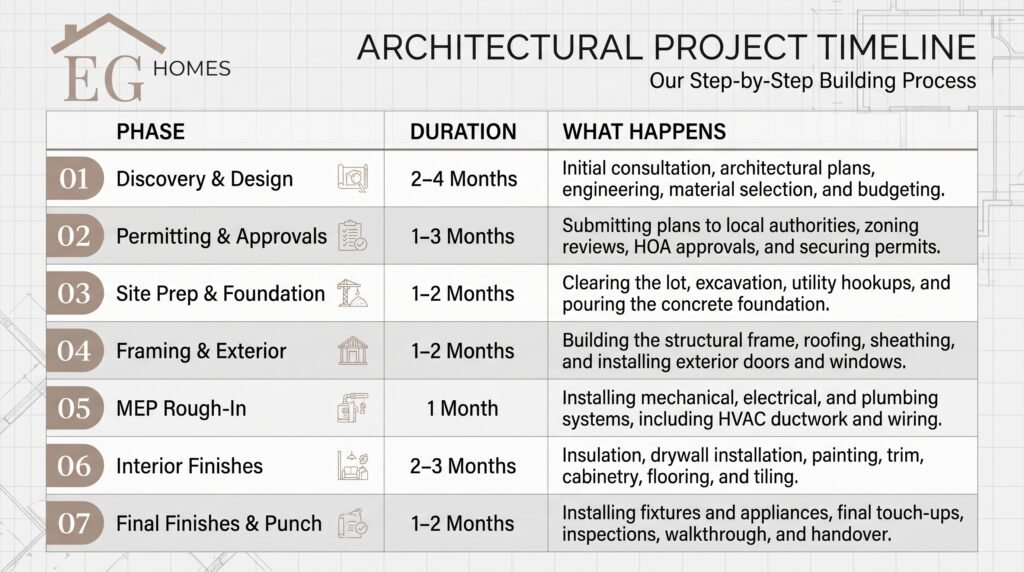

Custom Home Build Timeline: Design to Move-In
A realistic Delray Beach custom build takes 16 to 24 months from signed design contract to move-in day. Here is a phase-by-phase breakdown:

Timelines stretch when permit review takes longer (6+ months is not unusual for complex coastal builds), when materials are back-ordered, or when owners make significant mid-project changes.
How to Lower Custom Home Costs Without Lowering Quality
Six moves that reduce total spend by 15 to 30 percent without compromising the finished product:
- Simplify the roof. Every valley, dormer, and roof-plane change adds labor, flashing, and leak risk. A clean hip or gable roof over a rectangular footprint saves $30,000 to $100,000 and often ages better in a coastal environment.
- Right-size the footprint. A 4,000 sq ft home with luxury finishes almost always costs less and lives better than a 5,500 sq ft home with mid-range finishes. Spend on quality, not square footage.
- Standardize on fewer finish materials. One or two cabinetry profiles across the house, one or two stone selections, consistent flooring on each level. Variety drives waste and labor.
- Choose a cleared lot over a teardown. Teardowns can add $50,000 to $120,000 in demolition, debris, utility re-tap, and permitting, before construction begins. If keeping the existing shell is viable, a full whole-home remodel often delivers similar results for less.
- Lock finishes before groundbreak. Every change order after permit issue adds 15 to 40 percent to the base cost of that item. Decide early, order early, don’t change.
- Phase landscaping and the pool. Both can be completed within 12 months of move-in without affecting the certificate of occupancy, which can free $150,000 to $400,000 of your construction budget for interior quality.
Real Project Examples from Delray Beach
Three recent builds illustrate how finish level and lot condition shape the final number. Figures are indicative ranges, not exact contract totals.
East Delray Infill Build
- Specs: 3,800 sq ft, mid-range finishes, cleared inland lot
- All-In Cost: Approximately $2.1M
- Scope: Standard pool, two-car garage, impact windows throughout, semi-custom white oak cabinetry, quartz countertops
- Timeline: Delivered in 17 months
Lake Ida Renovation Plus Addition
- Specs: 4,600 sq ft finished, luxury finishes
- All-In Cost: Approximately $3.4M
- Scope: 1,200 sq ft second-story addition, full kitchen gut, primary suite expansion, new pool and outdoor kitchen
- Timeline: Delivered in 14 months
Historic Marina District New Construction
- Specs: 5,200 sq ft, ultra-luxury coastal
- All-In Cost: Approximately $6.2M
- Scope: VE flood zone, pilings foundation, imported Italian stone throughout, Crestron automation, wine room, three-car garage with lift
- Timeline: Delivered in 23 months
EG Homes Florida has completed 120+ projects across Palm Beach County since 2015. Each project is unique; figures above reflect comparable builds, not fixed pricing.
Ready to Price Your Delray Beach Custom Home?
Every lot, every design, and every finish schedule produces a different number. The fastest way to get a realistic figure for your specific project is a 30-minute consultation; we’ll review the lot, discuss your program, and give you a defensible budget range before you commit to design.
Schedule your free consultation or call (561) 400-5528.
Frequently Asked Questions
What’s the cheapest you can build a custom home in Delray Beach?
Realistically, $400 per square foot is the floor for a true custom build in Delray Beach in 2026; that assumes a cleared inland lot, a simple rectangular design, and entry-level finishes. Anything below that number is either a production home with custom branding or a budget that will be exceeded.
How much does a 3,000 sq ft custom home cost in Delray Beach?
Between $1.35M and $2.4M all-in, depending on finish level. A mid-range 3,000 sq ft build on a cleared inland lot runs approximately $1.8M including pool, landscaping, and standard allowances.
Is it cheaper to buy and renovate or build new in Delray Beach?
It depends on the existing home. If the structure is sound and the floor plan works, a renovation at $250 to $450 per square foot usually beats new construction. If the home needs structural work, systems replacement, and layout changes, a teardown and rebuild often costs the same or less than a deep renovation, and delivers a brand-new home
How long does it take to build a custom home in Delray Beach?
16 to 24 months from signed design contract to move-in for a typical build. Permitting alone takes 3 to 6 months in Palm Beach County, and complex coastal or historic-district projects can push total timelines past 30 months.
What’s included in the per-square-foot price?
It varies by builder, which is why per-square-foot numbers alone are a weak comparison tool. Our figures include hard construction, standard allowances, soft costs (architect, engineer, permits), site prep for a cleared lot, standard landscaping, and a mid-range pool. They exclude lot purchase, allowance overages, and ultra-custom add-ons like wine rooms or elevators.
Do I need an architect before I talk to a builder?
Not necessarily. Design-build firms like EG Homes Florida handle architecture, engineering, and construction under one contract, which usually saves 2 to 4 months of coordination time and 5 to 10 percent of total cost. If you’ve already engaged an architect, we can take over at any stage: schematic, design development, or construction documents.
What financing options exist for custom builds in Palm Beach County?
Most custom builds in this market are financed through construction-to-permanent loans from local banks (Seacoast, Valley, and First Horizon are active lenders) or paid in cash. Construction loans typically require 20 to 30 percent down, with draws released at defined construction milestones.
Can I see your past Delray Beach projects?
Yes, our project gallery shows completed builds across Delray Beach, Boca Raton, and Boynton Beach, including before-and-after photos of renovations. We can also arrange in-person walkthroughs of selected projects during an initial consultation.
